All Change Request Lists - Bulk Actions - Add Line Items to New Commitment Change Order

Suggested Prior Reading

All Change Request Lists - Bulk Actions - Commitments - New Change Order

View, Maintain and Save the new Line Items on the Commitment Change Order Schedule of Values

If the Change Request Schedule of Values Line Item are added to a new Commitment Change Order (see Suggested Prior Reading above), the New Commitment Change Order form displays. See Commitment Change Order – Add - Form Layout and Navigation for more information on the layout.

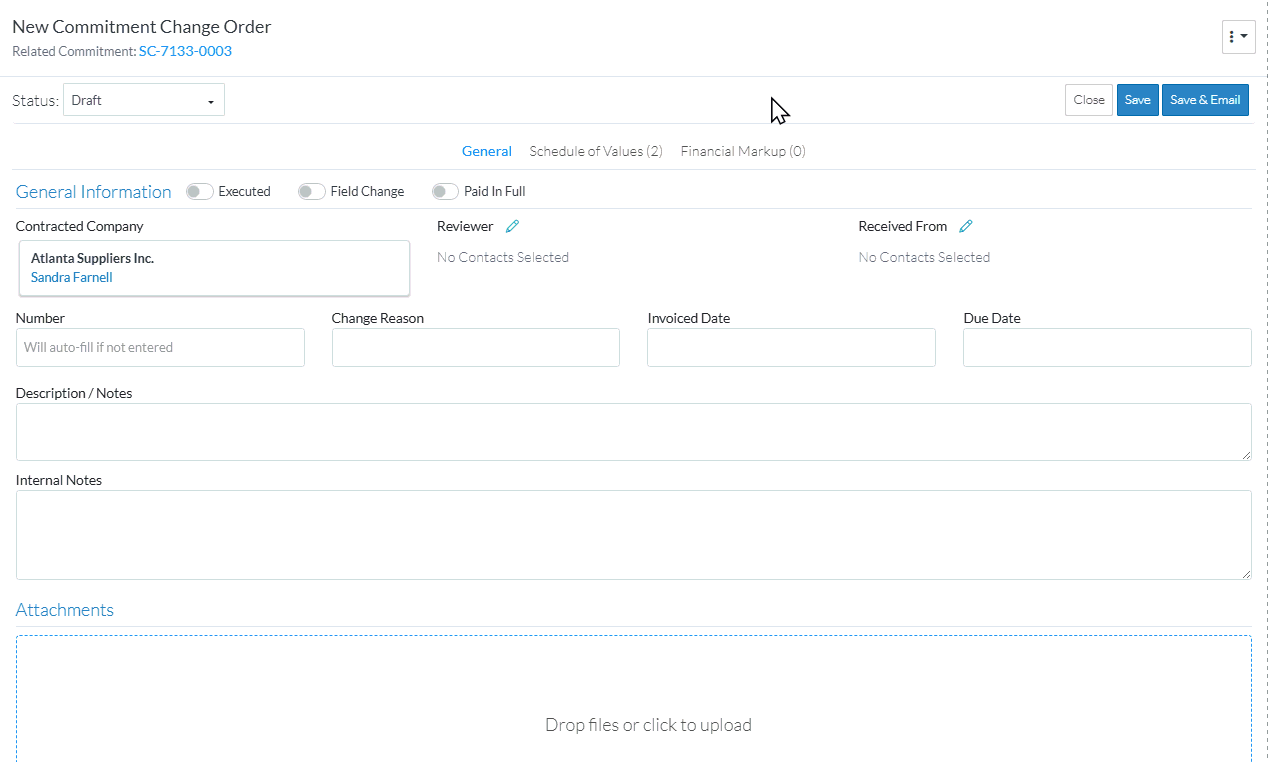

The General component displays by default during the add but other Components can be switched to via the Form Navigation Menu Options.

The Contracted Company automatically defaults to the Commitment Company and can not be changed.

  1. View the Commitment Change Order Schedule of Values by clicking on the Schedule of Values on the Form Navigation Menu Options on the New Commitment Change Order form.
    The Schedule of Values component for the Commitment Change Order displays.
    The Status of the Commitment Change Order will impact the display and what information can be edited (see Commitment Change Order - Status for more information).

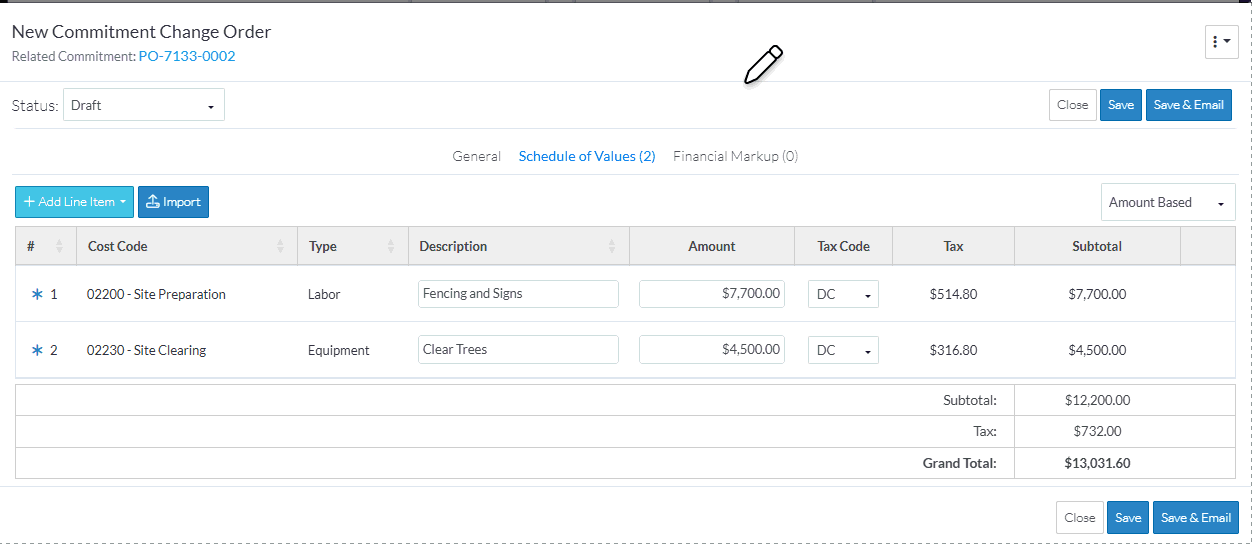

    ​Click here for an example of a Commitment Change Order with a Status that can be edited

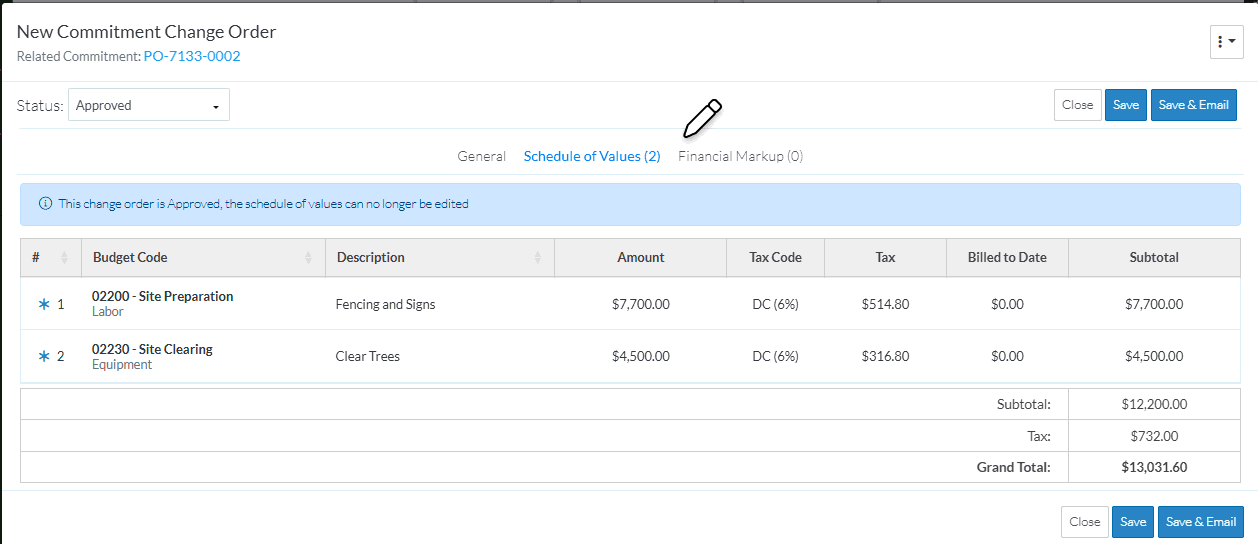

    Click here for an example of a Commitment Change Order with a Status that can not be edited

    The Schedule of Values is automatically populated with the Line Items that were selected on the Change Request Schedule of Values. They display with a * blue asterisk before the Line Item # to indicate they were created from a Change Request.
    Click here for more details on the information copied from Change Request Schedule of Values Line Items and what can be changed

    The new Commitment Change Order inherits the Accounting Method set for the Commitment it is associated to and can not be changed.

    The Sub Job (if used), the Cost Code and Cost Type are copied from the Change Request Schedule of Values Line Item and can not be changed. Note* The above example does not show Sub Jobs but if they were used they would display as the first column after the Line Number (see Sub Jobs - Overview).

    The Description is copied but can be changed.

    If the Change Request Schedule of Values is Amount Based and the Commitment Change Order Schedule of Values is Amount Based, the Revenue is copied to the Amount on the new Line Item. The Amount can be changed.

    If the Change Request Schedule of Values is Unit-Qty Based and the Commitment Change Order Schedule of Values is Unit-Qty Based, the Quantity, Unit of Measure and Unit Price are copied to the new Line Item. The Quantity and Unit Price can be changed.

    If the Change Request Schedule of Values is Amount Based and the Commitment Schedule of Values is Unit-Qty Based, the Quantity is set to 1, the Unit of Measure must be manually set and the Unit Price is set to the Revenue for the new Line Item. The Quantity and Unit Price can be changed.

    If the Change Request Schedule of Values is Unit-Qty Based and the Commitment Schedule of Values is Amount Based, the Revenue is copied to the Amount on the new Line Item. The Amount can be changed.

    The Tax Code is copied but can be changed. (The Tax Amount is calculated by multiplying the Tax Code percent on the Amount or the Qty multiplied by the Unit Price).

    Financial Markups from the Contract (which will also have been copied automatically to the Change Request), are not copied to an existing Contract Change Order (Financial Markups that previously existed on the Contract Change Order are not impacted)
    NOTE 1* Once a Line Item from a Change Request has been added to a Subcontract (and the Subcontract and its Schedule of Values saved) the Change Request Schedule of Values Line Item will be linked with the Subcontract and it can not be added to another Commitment or Commitment Change Order. The Line item can be deleted from the Subcontract and it will be automatically removed from the Line Item on the Change Request (i.e. it will no longer display in the Commitment column for the Line Item, but the rest of the Line Item is not impacted. It can then be added to a different Commitment or Commitment Change Order (see Commitment - Schedule of Values - Delete Line Item).
    Note 2* Even though the Line Items from the Change Request are displayed on the Subcontract, this is a working session and the Subcontract and its Schedule of Values must still be saved to save those Line Items.
  2. To maintain the Line Items added from the Change Request(s), see Commitment Change Order - Schedule of Values - Maintain when Line Items added from Change Requests.
  3. Maintain other Line Items or other information (see More Information below).
    OR
    Click the Save button (at the top or bottom of the form) to save the Commitment Change Order.
    Click here for more information on the Save function.
    This saves the Commitment Change Order including any information on the General, Schedule of Values and Financial Markups Components.
    This list the function was invoked from displays. See Next Steps below.
    OR
    Click the Save & Email button (at the top or bottom of the form) to save the Commitment Change Order and email it.
    Click here for more information on the Save and Email function.
    This saves the Commitment Change Order including any information on the General, Schedule of Values and Financial Markup components and sends an email with a link to the Commitment Change Order in JobPlanner (and optionally include the Commitment Change Order as a PDF attachment in the email). The Email can be sent to any Project Contacts. The Email Commitment Change Order form displays, see Email Commitment Change Order.
    OR
    Click the Close button (at the top or bottom of the form) to close the form without saving the Commitment Change Order.
    Click here for more information on the Close function.
    If no information was changed or entered, the list the add function was invoked from displays, see Next Steps below.

    If information was changed, then an additional prompt displays indicating there were changes and additional prompts on what to do.



    Click the Cancel button to cancel the Close action and return to the Purchase Order - View/Edit form (see the steps above)
    OR
    Click the Don't Save button to cancel changes to the Purchase Order. The list the add or edit function was invoked from displays, see Next Steps below.
    OR
    Click the Save button to save the Purchase Order including any information on the General, Schedule of Values or Financial Markups components. The list the add or edit function was invoked from displays, see Next Steps below.

More Information

To add more Line Items, see Commitment - Schedule of Values - Add Line Item.

To bulk import Line Items, see Commitment - Schedule of Values - Import.

To delete Line Items, see Commitment - Schedule of Values - Delete Line Item.

To maintain the General Information for the Commitment Change Order, see Commitment Change Order - Add/View/Edit - General.

To maintain Financial Markups for the Commitment Change Order, see Commitment - Financial Markup - Overview.

Next Steps

For the Change Requests List, see Change Requests List - Overview (Grouped List View).

For the Contract List of All Change Requests, see Contracts - List of all Change Requests - Overview (Grouped List View).


How did we do?


Powered by HelpDocs (opens in a new tab)

Powered by HelpDocs (opens in a new tab)
